Retractable paint booth on floor rails for steel structures and oversized workpieces: it folds back so cranes set the part down, then extends to cover it.
Retractable paint booth that travels on floor rails: the enclosure folds back so cranes set the workpiece down, then extends to cover it — flame-retardant PVC fabric on folding steel frames, explosion-proof lighting and drives, dry-filter or oil-film paint mist capture, and carbon, UV or RCO exhaust treatment matched to the fan. MUSI Technology manufactures telescopic mobile spray booths in Changzhou, China, and ships them as complete units with on-site installation and operator training.
Built for steel structures, pressure vessels, tanks, machinery frames and wind and crane components that are too long or too heavy to move into a fixed booth.
Structural steel fabricators, pressure vessel and tank builders, construction and mining machinery plants, wind tower and crane component makers, shipyards and any workshop where the crane, not a conveyor, moves the workpiece.
Telescopic enclosure: folding steel frames, flame-retardant PVC fabric, roof and side lighting, floor rails
Dual explosion-proof drive with chain-linked twin wheels, double limit switches and automatic drift correction at each end
Dry paint-mist filter wall (labyrinth paper and glass-fibre bags) or oil-film purifier at the exhaust end
Exhaust treatment: activated carbon boxes, UV photo-oxidation unit, or RCO with three carbon beds and a catalytic bed
Centrifugal exhaust fan on anti-vibration mounts, galvanised ducting and 15 m stack
Control cabinet with jog buttons, emergency stop, VFD and grouped lighting control
Send us your largest workpiece size and paint type, and our engineers will return a booth layout and quotation. Contact us
Need a custom coating line for your factory?
Tell us about your workpieces and capacity requirements. Our engineers reply within 24 hours; a tailored configuration and quotation follow once your part data is complete.
Values below are typical ranges taken from telescopic booths we have engineered; the figures for your booth are fixed in the written specification after we review your workpieces, paint consumption and site.
Item
Specification
Internal size
Typical 12-20 m long, 5-10 m wide, 3-4.5 m high; length in 1 m frame modules
Maximum build size
Up to 100 m long, 35 m wide and 9 m high with a custom-engineered frame and drive design
Retracted footprint
Typical 3 m long for a 20 m booth (about 15% of the extended length)
Travel
8-10 m/min on 12 kg/m light rail (large booths) or flat bar rail (small booths)
Frames and fabric
Q235 steel frames 50 x 70 x 2 mm, scissor bracing 50 x 25 x 2 mm; flame-retardant PVC fabric 0.5 mm, blue outside / white inside
Drive
Two explosion-proof geared motors 1.5-3 kW with interlock, double limit switches at both ends, anti-slip twin drive wheels, rail sweeper
Lighting
Explosion-proof LED, 300 lux or more at the work surface (18 W units, typical 60-100 per booth)
Cross-draft velocity
0.3 m/s or more across the booth section; duct velocity 12 m/s or less
Paint mist capture
Dry filter (labyrinth paper plus glass-fibre bag, 98% or more) or oil-film purifier (98% or more)
Exhaust treatment
Activated carbon, UV photo-oxidation, or adsorption-desorption with catalytic oxidation (RCO), 30,000-80,000 m3/h
Exhaust fan
Typical 45-75 kW centrifugal fan, 54,000-79,400 m3/h for a 20 x 10 x 4 m booth; 15 m stack
Noise
80 dB(A) or less inside the booth, 85 dB(A) or less at the fan
Control
Jog control for travel, two-station control cabinet, VFD on the exhaust fan, audible and visual alarms, phase-loss and overload protection
Indicative price range
USD 10,000 – 1,000,000, depending on the solution and configuration
Smaller booth configurations, indicative price
USD 10,000 – 200,000
Mid-range booth configurations, indicative price
USD 300,000 – 500,000
Large custom-engineered booths, indicative price
USD 700,000 – 1,000,000
Larger sizes and special configurations are engineered to order.
Further Reading
Paint mixing room for liquid spray lines Explosion-protected room where liquid paint is stored, mixed, filtered and pumped to the spray booths — ventilation, temperature control, paint...
Sandblasting room with abrasive recovery Walk-in blast room for containers, steel structures, tanks and large weldments — floor abrasive recovery, air-wash separator, cartridge dust collection...
Liquid spray lines Liquid spray coating lines with water-based, solvent-based and 2K paint systems: wet booths, flash-off, drying ovens and conveyors sized to your parts.
VOC and environmental equipment RTO, zeolite rotor concentrators, activated carbon and paint wastewater treatment sized for spray and powder coating line emission compliance.
Telescopic Spray Booth in Practice

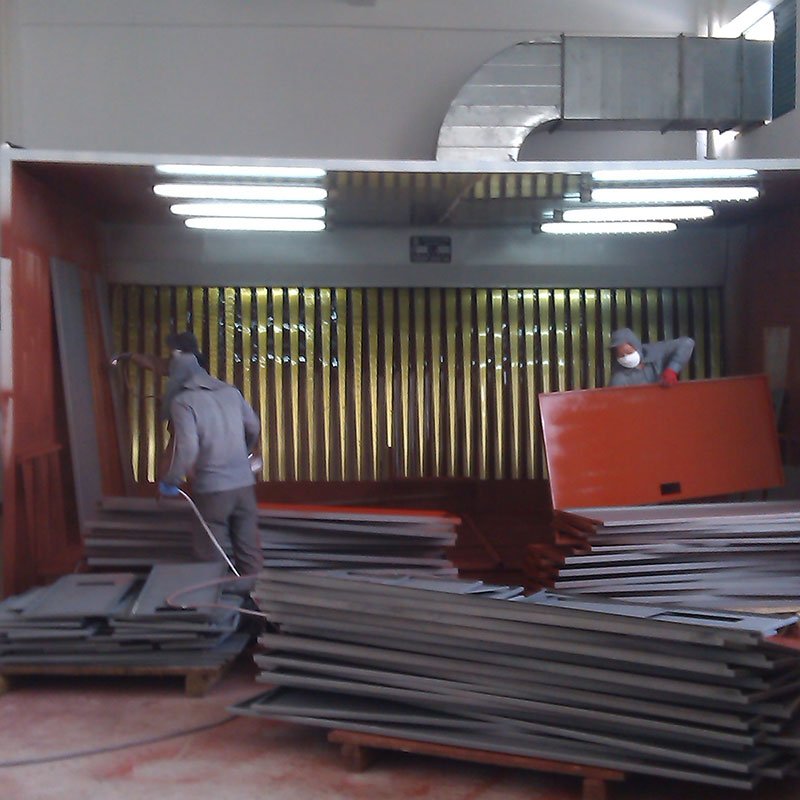

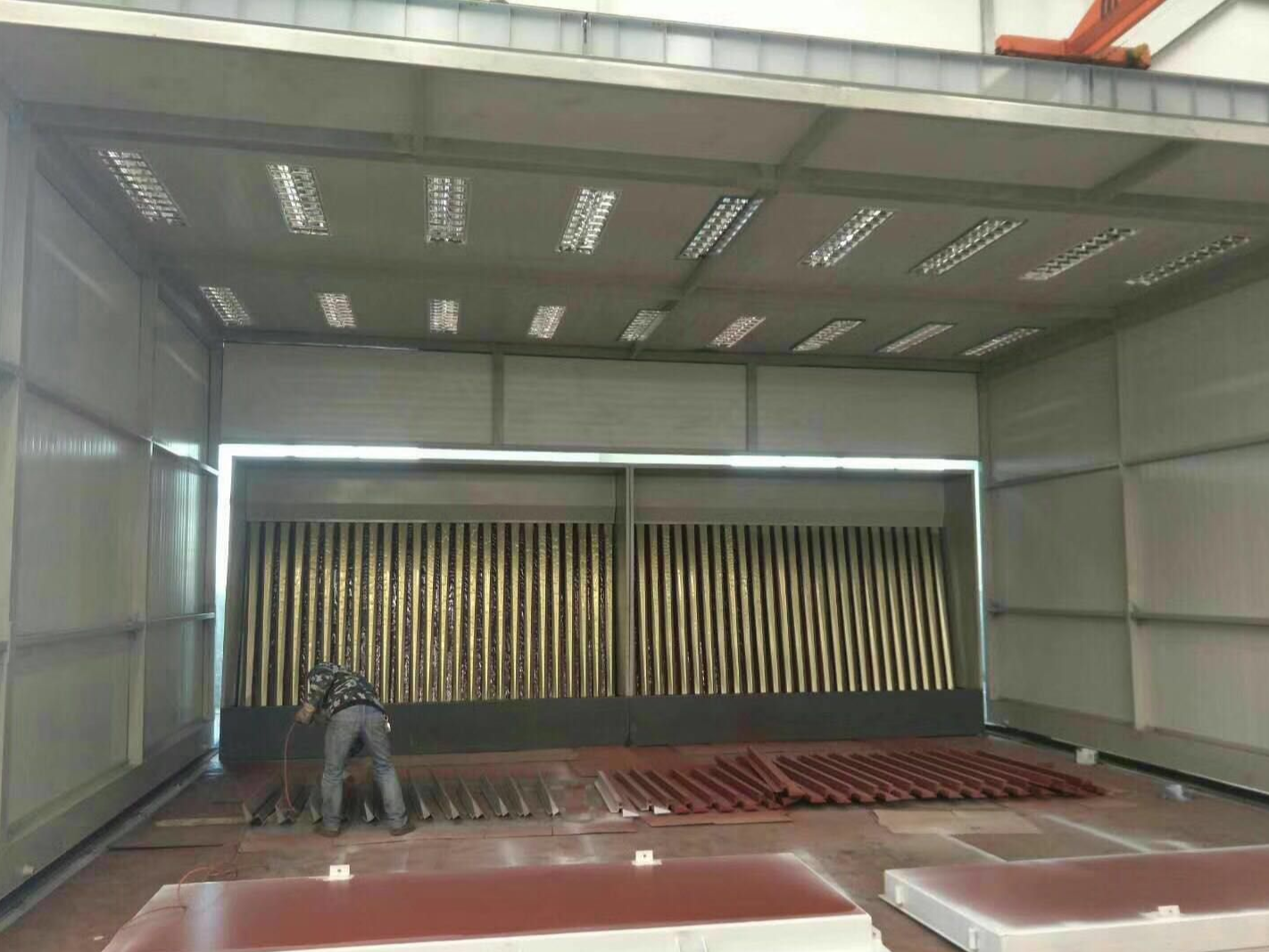

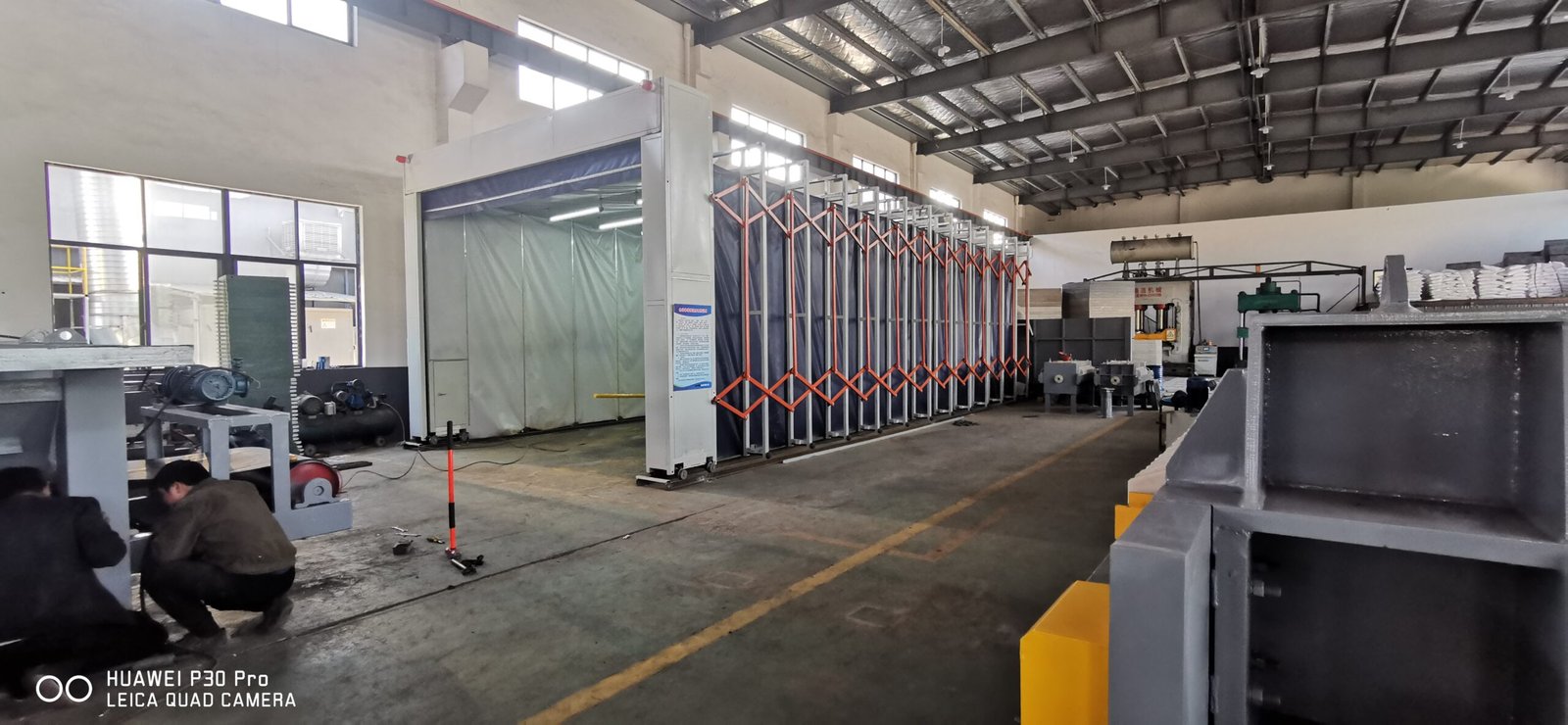

Photos from telescopic booths supplied for steel structure, pressure vessel and heavy fabrication workshops: the enclosure retracted for crane loading, the dry filter cabinet at the exhaust end, and an outdoor rail-mounted booth under a gantry crane.

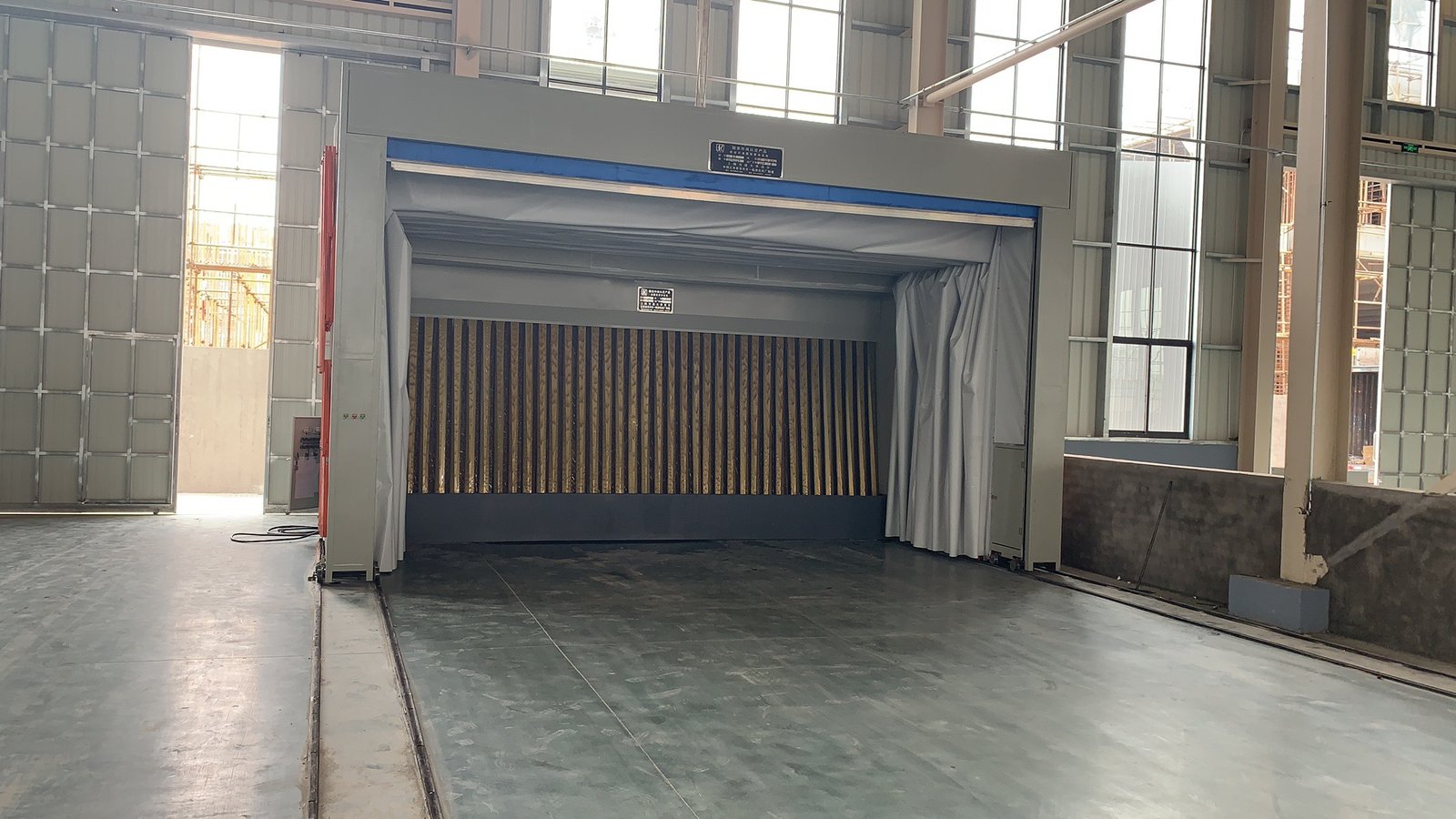

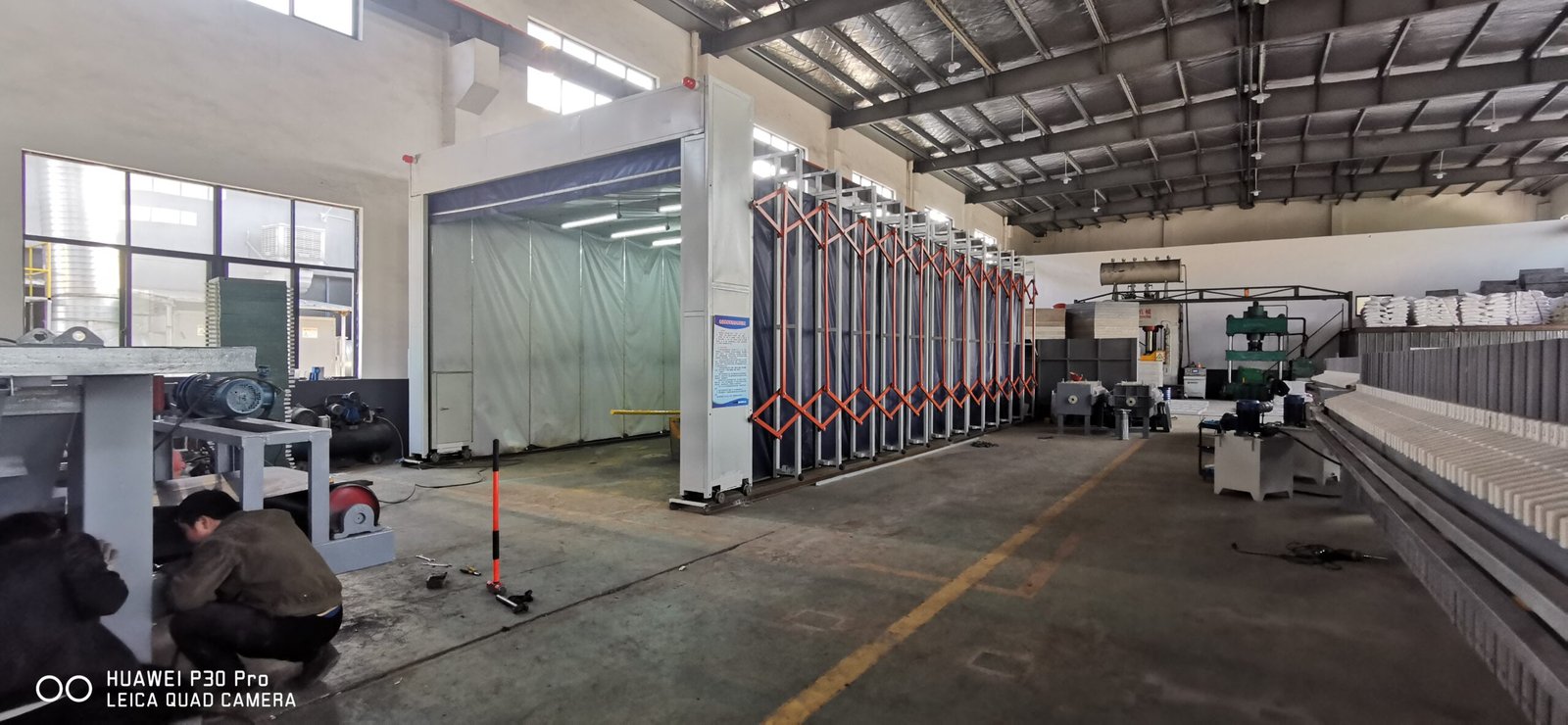

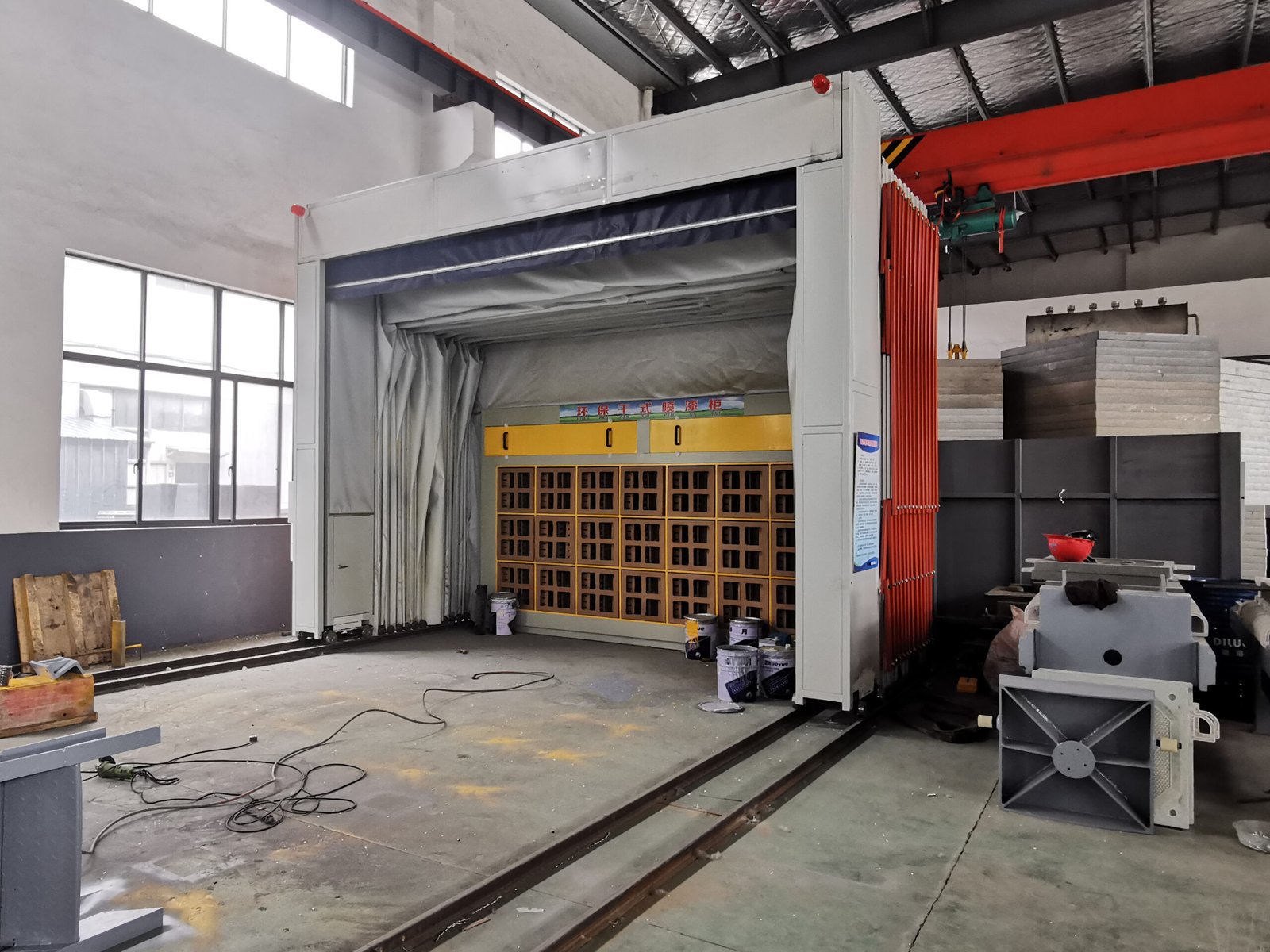

Dry filter cabinet with labyrinth paper filters at the exhaust wallSide view of the folded enclosure and fixed end
Engineering Commitment
Every booth is engineered against a written performance specification. Enclosure size, cross-draft velocity, paint mist capture, exhaust treatment efficiency and noise are stated in the contract and demonstrated at commissioning. One engineering team owns the enclosure, the drives, the filtration and the exhaust treatment, so the trade-offs between them are settled on the drawing board, not on your factory floor.
Service & Delivery
Standard configurations ship in 30-60 days with a 12-month full-machine and 36-month critical-component warranty. On-site installation, commissioning and operator training are available worldwide, and filter media and spare parts support continue for the working life of the booth. Structural parts are covered for up to 60 months.
What to send for a quotation
Sizing a telescopic booth? Send the largest workpiece dimensions (L×W×H), weight, paint type and daily number of pieces, and the booth size and exhaust treatment follow.
What to send for a quotation: part drawings or photos, the largest part size and weight, the material, the required output per shift and cycle time, the coating type (powder, liquid, UV or 2K) and the number of colours, and the available floor space, ceiling height, power or gas supply and local emission requirements.
Tell us about your workpieces and capacity requirements. Our engineers reply within 24 hours; a tailored configuration and quotation follow once your part data is complete.
How does a telescopic spray booth differ from a fixed booth?
The enclosure travels on rails and folds to a fraction of its length, so the overhead crane places the workpiece on the floor first and the booth closes around it. A fixed booth needs the part to be carried in through a door, which is not practical for 15 m beams or 10 t vessels.
Dry filter or oil-film purifier?
Dry filters (labyrinth paper plus glass-fibre bags) suit intermittent painting and plants without a water or oil treatment routine; the filters are replaced when the pressure drop reaches about 250 Pa. Oil-film purifiers suit heavier daily paint use and are followed by carbon adsorption or RCO.
Which exhaust treatment do I need?
It follows the paint volume and the local emission limit. Low-volume, intermittent painting is usually met with activated carbon boxes; higher volumes or stricter limits use UV photo-oxidation plus carbon or an RCO that regenerates the carbon beds with catalytic heat.
Can the booth be installed outdoors?
Yes. Rail-mounted booths are installed in yards under a gantry crane with the exhaust unit fixed at one end; the fabric is UV-stabilised and the drives and lighting are explosion-protected.
What do you need for a quotation?
The largest workpiece length, width and height, the crane hook height, daily paint consumption and paint type, the local VOC emission limit and whether the booth is indoors or outdoors.
How much does a telescopic spray booth cost?
As a budgeting guide, a MUSI telescopic spray booth costs from about USD 10,000 to USD 1,000,000. The exact price depends on the solution and configuration; send us your largest workpiece size and paint type for a firm quotation.
Q
Questions buyers ask before ordering
quotation · price · lead time · installation · warranty
What information do you need to prepare a quotation?
Send part drawings or photos, the largest part size and weight, the material, the required output per shift, the paint or powder type and number of colours, and the available floor space, ceiling height and power or gas supply. MUSI engineers reply within 24 hours; a recommended configuration and quotation follow once your part data is complete.
How much does this equipment cost?
Budget depends on part size, throughput and the level of automation. Indicative ex-works ranges are published in our liquid spray line cost guide; a configured quotation is prepared from your part data. Published indicative ranges: compact manual liquid spray booths from around USD 15,000–40,000, semi-automatic lines with conveyor and flash-off/curing ovens roughly USD 80,000–400,000, and fully automatic multi-colour electrostatic lines from USD 400,000 to several million dollars.
What is the lead time?
Standard configurations ship in 30–60 days from contract signing and down payment; custom configurations take longer. The delivery date is fixed in the contract.
Do you install and train operators overseas?
Yes. MUSI engineers carry out on-site installation and commissioning and give 3–5 days of operator and maintenance training. MUSI has delivered 800+ coating lines to customers in 36 countries.
What warranty and after-sales support are included?
12 months full-machine warranty, 36 months on critical components and up to 60 months on structural parts. International customers get 24-hour phone response and 72-hour on-site arrival; spare parts ship from the Changzhou headquarters.
Can the environmental equipment be supplied with the line?
Yes. VOC treatment (RTO, RCO, activated carbon, zeolite rotor), dust collection and paint wastewater treatment are supplied with the coating line under one contract; MUSI has equipped 50+ coating facilities whose projects all passed local environmental compliance reviews.
Manufacturer: MUSI Technology (Changzhou MUSI Environmental Technology Co., Ltd.), Changzhou, China. MUSI designs, builds and installs this equipment as a single unit or as part of a turnkey coating line.
Item
Specification
Internal size
Typical 12-20 m long, 5-10 m wide, 3-4.5 m high; length in 1 m frame modules
Maximum build size
Up to 100 m long, 35 m wide and 9 m high with a custom-engineered frame and drive design
Retracted footprint
Typical 3 m long for a 20 m booth (about 15% of the extended length)
Travel
8-10 m/min on 12 kg/m light rail (large booths) or flat bar rail (small booths)
Frames and fabric
Q235 steel frames 50 x 70 x 2 mm, scissor bracing 50 x 25 x 2 mm; flame-retardant PVC fabric 0.5 mm, blue outside / white inside
Delivery record
800+ coating lines for 500+ clients in 36 countries (MUSI engineering team, cumulative since 2011)
Services
Design, manufacturing, installation, commissioning, operator training and after-sales support from one company
Specifications, delivery and support
What are the main specifications of the Telescopic Mobile Spray Booth?
Standard specifications are:
Item
Specification
Internal size
Typical 12-20 m long, 5-10 m wide, 3-4.5 m high length in 1 m frame modules
Maximum build size
Up to 100 m long, 35 m wide and 9 m high with a custom-engineered frame and drive design
Retracted footprint
Typical 3 m long for a 20 m booth (about 15% of the extended length)
Travel
8-10 m/min on 12 kg/m light rail (large booths) or flat bar rail (small booths)
Frames and fabric
Q235 steel frames 50 x 70 x 2 mm, scissor bracing 50 x 25 x 2 mm flame-retardant PVC fabric 0.5 mm, blue outside / white inside
Drive
Two explosion-proof geared motors 1.5-3 kW with interlock, double limit switches at both ends, anti-slip twin drive wheels, rail sweeper
Lighting
Explosion-proof LED, 300 lux or more at the work surface (18 W units, typical 60-100 per booth)
Cross-draft velocity
0.3 m/s or more across the booth section duct velocity 12 m/s or less
Paint mist capture
Dry filter (labyrinth paper plus glass-fibre bag, 98% or more) or oil-film purifier (98% or more)
Exhaust treatment
Activated carbon, UV photo-oxidation, or adsorption-desorption with catalytic oxidation (RCO), 30,000-80,000 m3/h
Exhaust fan
Typical 45-75 kW centrifugal fan, 54,000-79,400 m3/h for a 20 x 10 x 4 m booth 15 m stack
Noise
80 dB(A) or less inside the booth, 85 dB(A) or less at the fan
Control
Jog control for travel, two-station control cabinet, VFD on the exhaust fan, audible and visual alarms, phase-loss and overload protection
Indicative price range
USD 10,000 – 1,000,000, depending on the solution and configuration Smaller booth configurations, indicative price: USD 10,000 – 200,000 Mid-range booth configurations, indicative price: USD 300,000 – 500,000 Large custom-engineered booths, indicative price: USD 700,000 – 1,000,000
Figures outside these ranges are met with a custom-engineered build.
What does the Telescopic Mobile Spray Booth cost and how long is the lead time?
Price is quoted per project, because every unit is configured to the buyer requirements, parts and production volume. Standard configurations ship in 30-60 days with 12/36/60 months warranty (complete line / critical components / structural parts). On-site installation, commissioning and operator training are available worldwide. Structural parts are covered for up to 60 months.
Telescopic mobile spray booth price range
Indicative price range USD 10,000 - 1,000,000, depending on the solution and configuration.
